Capestone 11kV Cable Installation

G T Jones’s debut run with the brand new Tesmec 400MTC Trencher at Capestone, Haverfordwest laying 11kV cable under roadways over 1200m.

client Icon
CLIENT
location-icon
LOCATION
categories-icon
SERVICE
11kV Cable Installation
completed-icon
COMPLETED
February 2026 – 4 weeks

Project Overview

The Capestone project near Haverfordwest, Pembrokeshire involved the installation of over 1200m of 11kV electrical cable along a network of public roadway. The works were undertaken within a live highway environment and required careful planning, coordination and traffic management to ensure the safety of the workforce, road users and local residence while maintaining access wherever practicable.

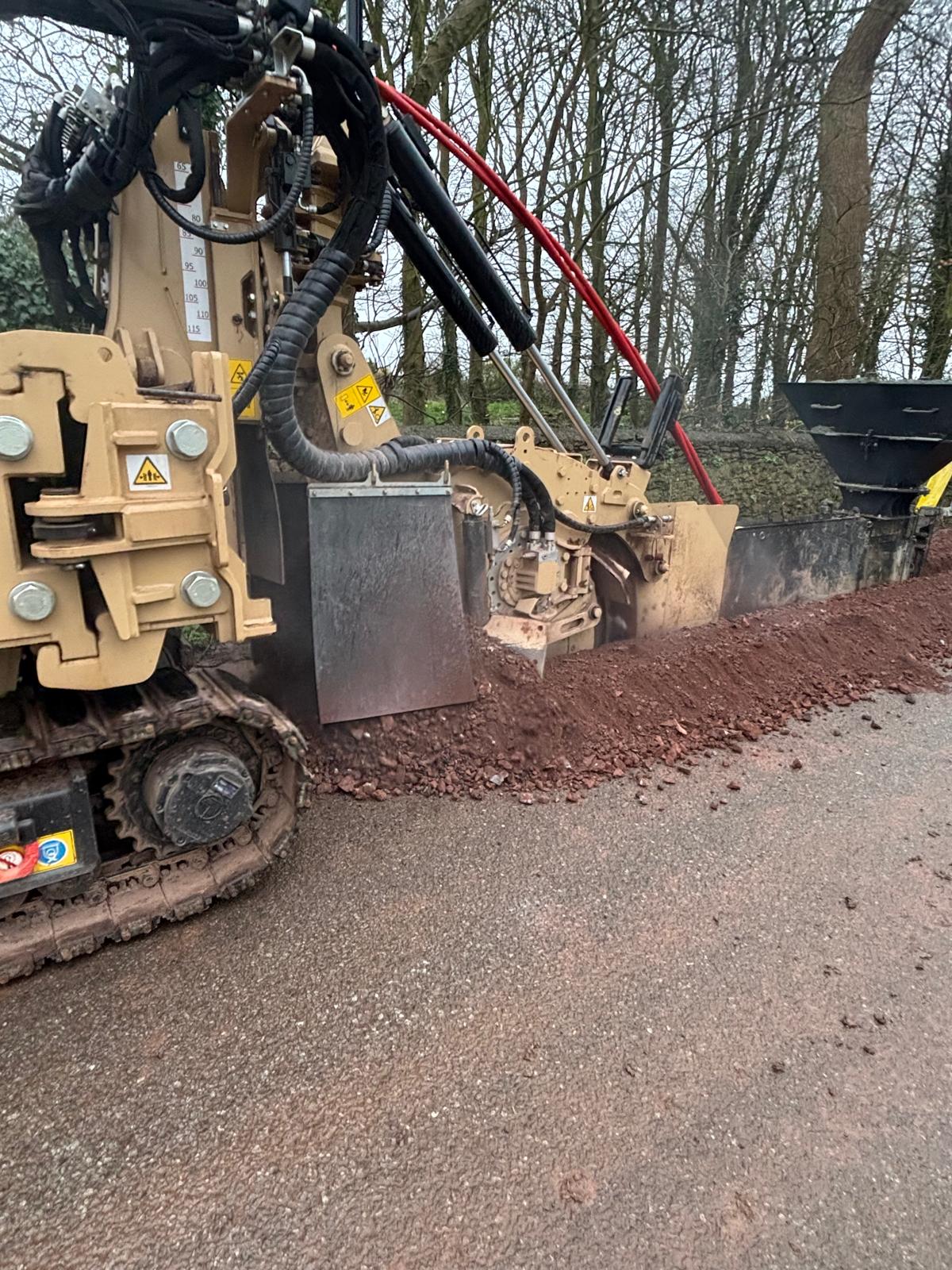

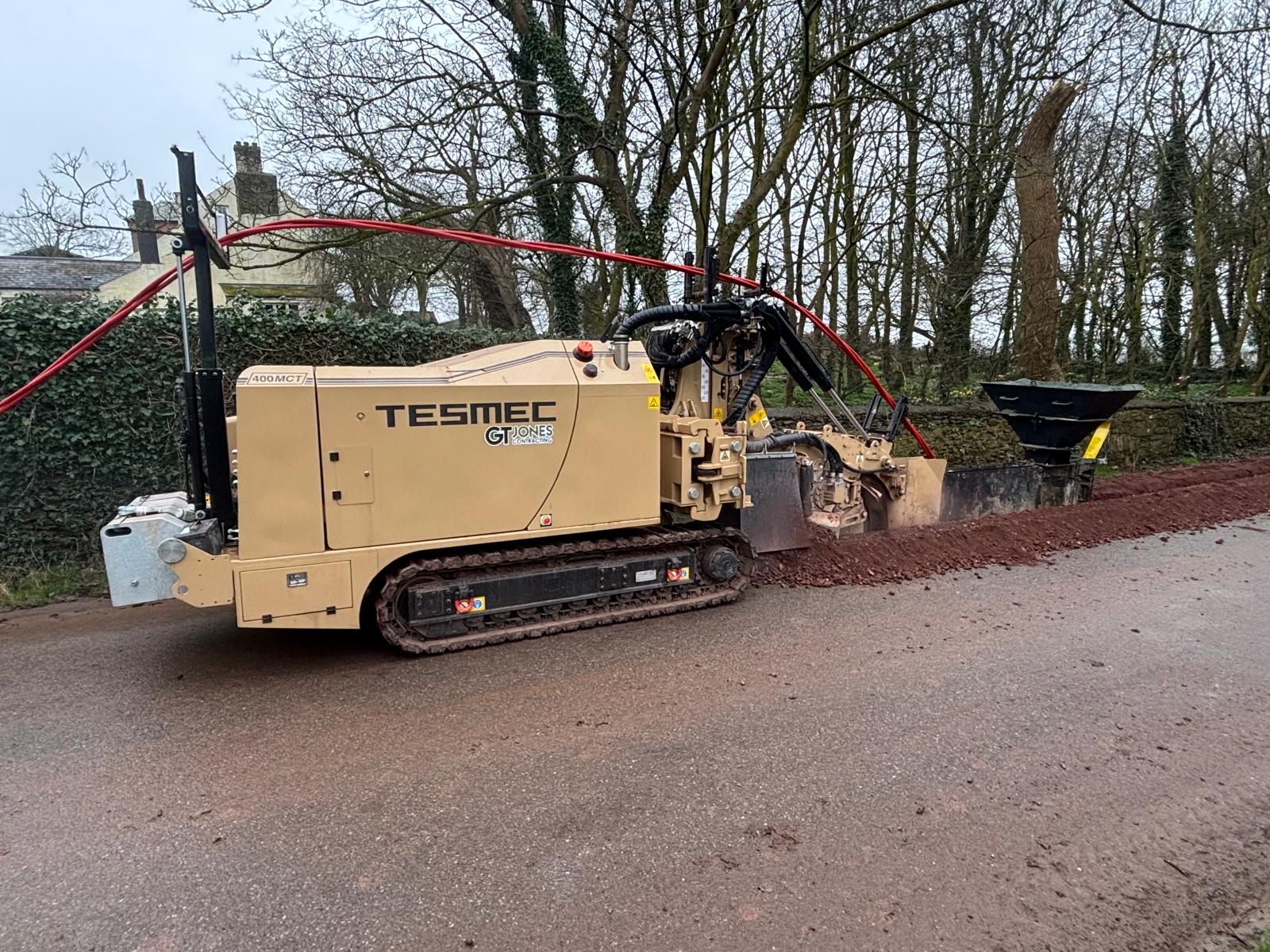

A key element of the project was the use of the Tesmec 400MTC Trencher fitted with specialist rock wheel attachment, which enabled the team to efficiently cut through a variety of challenging ground conditions, including the existing tarmac and rock along the route. The use of this specialist trencher provided significant benefits compared with conventional excavation methods, including increased productivity, consistent trench dimensions, reduced excavation time and reduction in the amount of spoil generated.

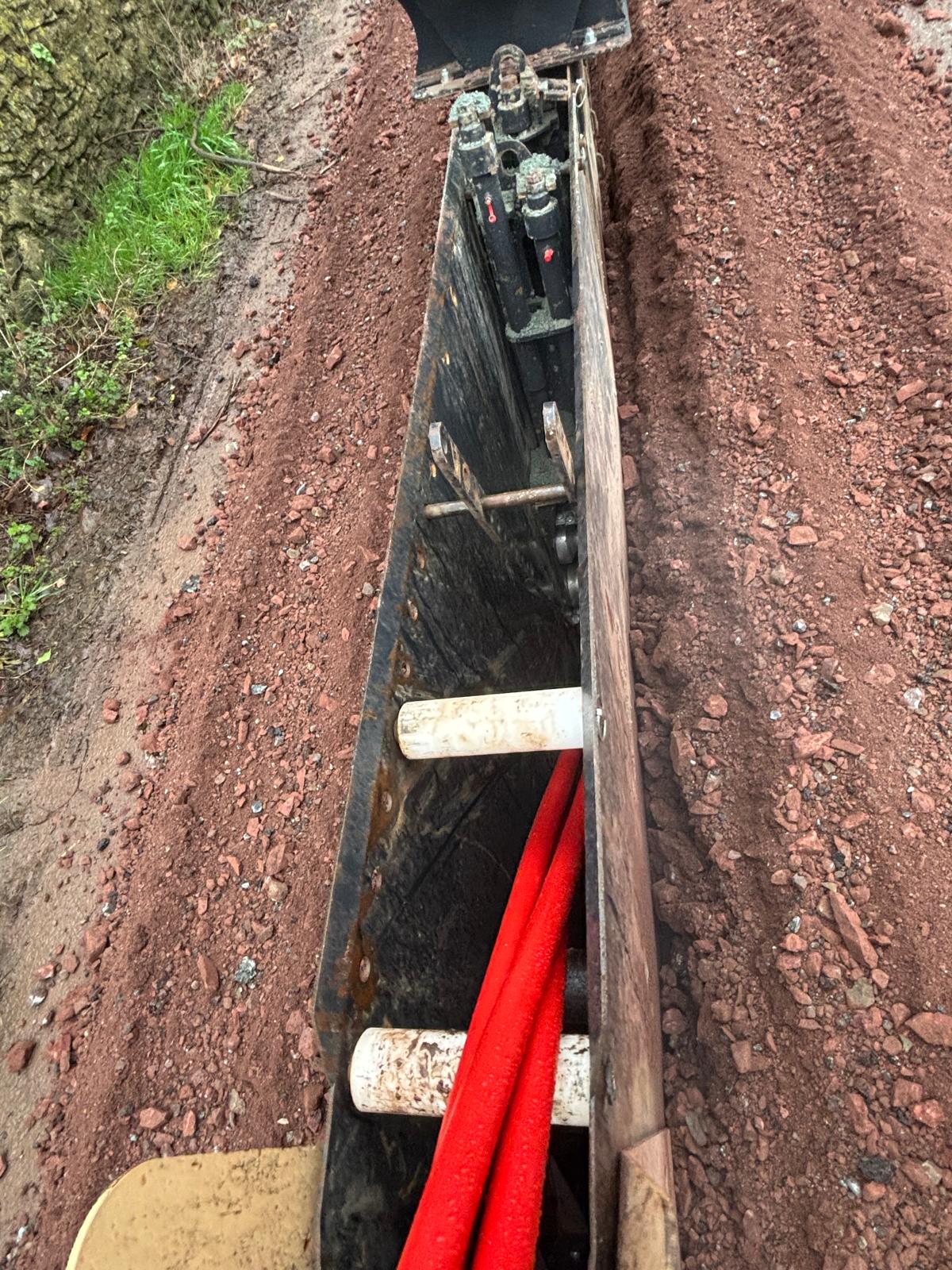

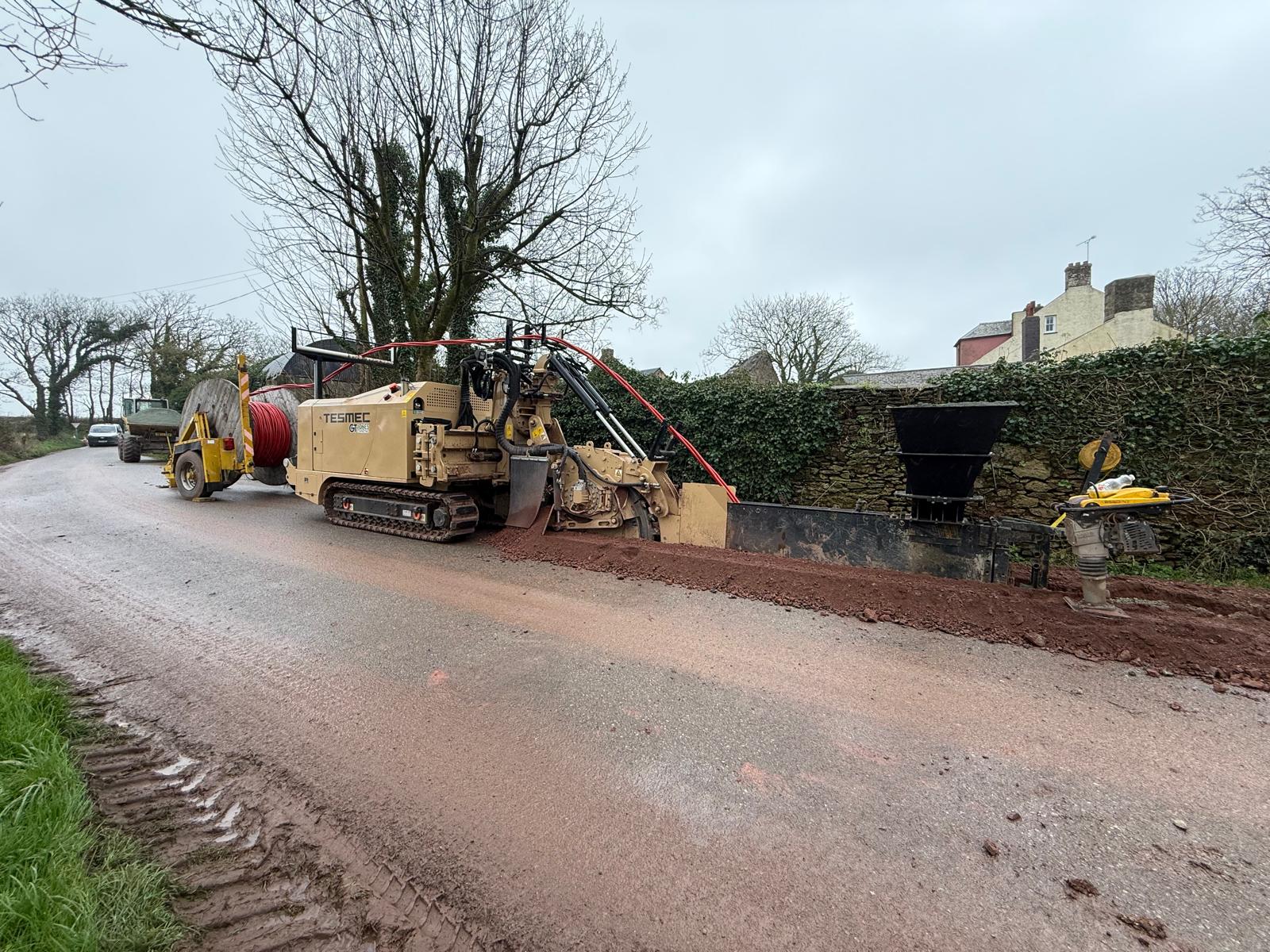

A significant part of the project was the reinstatement of the road following the cable installation. Reinstatement works were carefully coordinated with the trenching and cable installation activities to minimise the time that sections of the road remained under traffic management or closure. Trench was backfilled using suitable approved materials and compacted in controlled layers to provide a stable foundation then finished with tarmac surface to bring it back to its original state.

Overall, the Capestone project demonstrated the benefits of using specialist trenching technology. The ability to cut efficiently through difficult surfaces, combined with carefully managed road closures and traffic management, helped the project team maintain productivity while safely delivering the works within a challenging live-road environment.

Project Outcomes

  • Precise and efficient trench excavation through the road structure
  • Accurate trench depth and alignment ensured compliance with utility installation standards
  • Full reinstatement of the tarmac road surface to restore access and maintain road integrity
  • Traffic management maintained safe vehicle movement and protected the workforce
  • All works delivered on time, safely and to a high standard.
Capestone 1.2km Installation
Scroll to view full comparison
Metric Traditional Open Cut Tesmec Trencher Estimated Saving Comment
Programme Approx. 31 days 21 days 32% faster Based on 40m/day traditional dig and recorded/assumed trencher programme
Fuel Approx. 2,600L Approx. 585L 78% reduction Open cut = 2,000L/km. Trencher = 450L/km
Carbon Approx. 6.5tCO2e Approx. 1.46tCO2e 78% reduction Based on fuel assumptions using approx. 2.5kg CO2e/L diesel
Excavated spoil Approx. 520m³ Approx. 195m³ 63% reduction Open cut = 400m³/km. Trencher = 150m³/km
Project Highlight

The Tesmec Trencher allowed works through a sensitive access route to be completed over two night shifts, compared with an estimated five days using traditional open-cut excavation. This reduced disruption, shortened the construction programme and allowed surrounding activities to continue with minimal impact.
